The Shutdown Is Still Writing Sole-Source Justifications
NAVFAC Northwest raised an architect-engineer vehicle's ceiling by $27 million yesterday without competing it, and the justification it published today names the cause: a selection board that the October 2025 funding lapse knocked off schedule. The replacement contract has been in evaluation for 357 days.
NAVFAC Northwest put the replacement for its multi-discipline architect-engineer vehicle on SAM in July of last year. Proposals came in three weeks later.
The last thing that ever happened to that notice was the site archiving it, ten seconds after midnight on October 1, 2025. The funding lapse started a minute after that.
Nothing has touched the record since.
Yesterday the Navy paid for it. Rogers, Lovelock & Fritz took a $27,000,000 ceiling increase on contract N44255-20-D-0002, no competition, and this afternoon NAVFAC published the justification that explains why (chart below).
The document is J&A No. 26-04JA, and it is the most candid thing the command has said about this competition since the synopsis went up last July.
"What does a 43-day funding lapse still cost, ten months after it ended?"
On this one contract, at this one command: $27,000,000, and no competition for any of it.

The Clock Was Already Handled

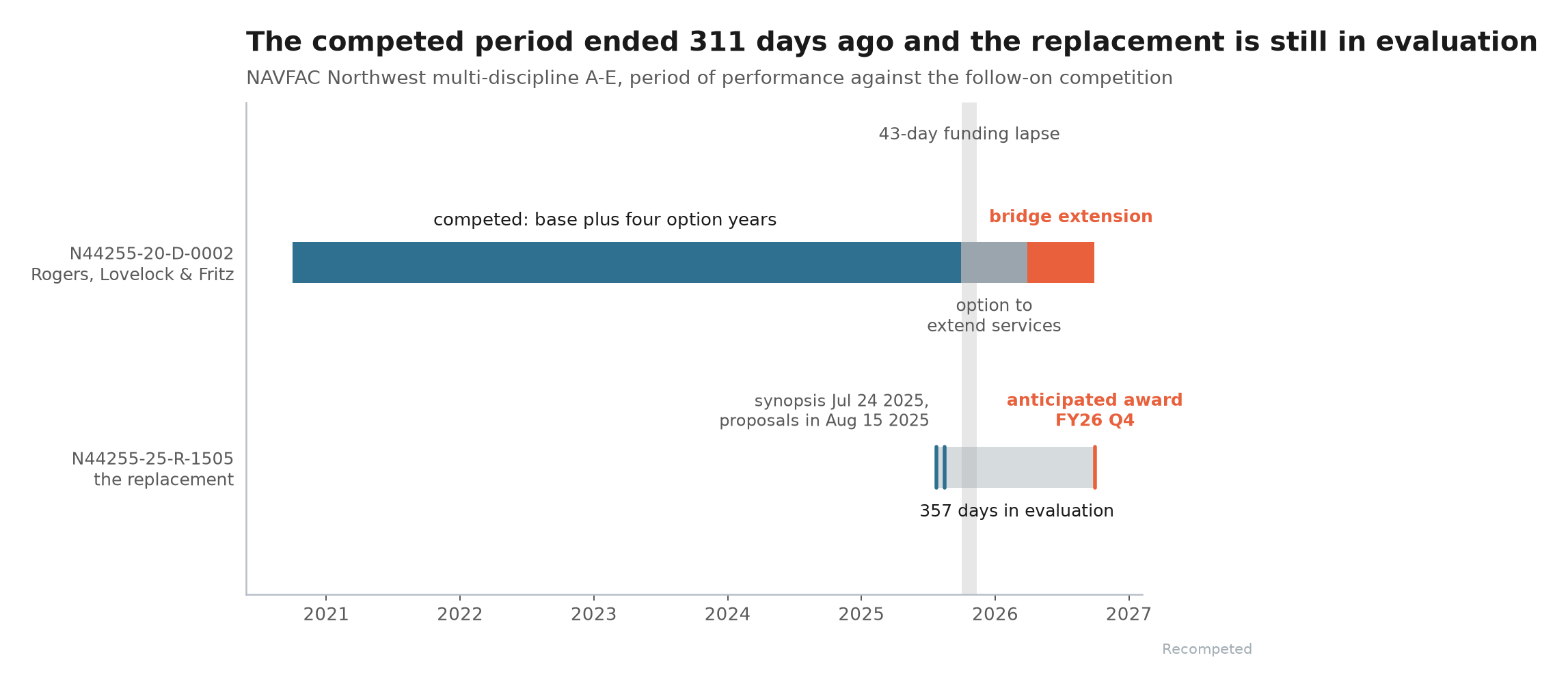

Read the period-of-performance table in the J&A and the interesting thing is what NAVFAC did not need yesterday.
The vehicle was competed full and open in 2020, four proposals, no set-aside, and it ran a base year plus four options to September 30, 2025. Then P00013 exercised the option to extend services, which under FAR 52.217-8 buys six months and not a day more. That carried the work to March 29, 2026.
Then the command went to a bridge. Modification P00014, the Annex 5 action approved under NMCARS 5206.104-2-90 in late March, pushed the end date to September 29, 2026, and USAspending shows P00015 following days later to do nothing except update the completion date to match.
So the incumbent already had a year of runway stacked on a five-year contract, in two six-month pieces, from two different authorities.
What ran out was the money. The not-to-exceed value including all options was $100,000,000, and by this summer the J&A puts remaining available capacity at roughly $22,500,000, excluding a $5M modification reserve.
Against the projects NAVFAC had already lined up for the extension period, that left a calculated shortfall of $27,060,025.
A bridge that extends the calendar and not the ceiling is half a bridge. Yesterday's mod was the other half.
