Most SABER Handoffs Don't Hand Off

We pulled every Simplified Acquisition of Base Engineering Requirements vehicle in the Air Force record: 65 contracts across 34 contracting activities. Ten of the 17 handoffs between generations left the base with no SABER on the street, for a median of 260 days, and the two worst gaps in the whole record both closed this year.


On May 1, 2007, the 99th Contracting Squadron put a SABER on contract at Nellis. The ordering period on that vehicle ran out in August 2013, and the next one did not start until December 2016.

Three years and four months with nothing.

Last week the 99th did it again, and bigger.

The Oct. 6 Department of War board carries FA4861-26-D0008, a ceiling $185,000,000 IDIQ to Weldin Construction for Simplified Acquisition of Base Engineering Requirements at Nellis, Creech and the Nevada Test and Training Range, competitive, six offers, awarded Sept. 30.

The vehicle it replaces stopped taking orders on Dec. 20, 2021.

That is 1,745 days between the last date to order and the new award. Four years and nine months.

Ten of Seventeen

We pulled every indefinite-delivery contract in the federal award record whose description carries the program's full name. 65 of them, every single one Air Force, spread across 34 contracting activities, 63 of the 65 coded NAICS 236220.

Sixty are set aside in some form and 50 of those are 8(a).

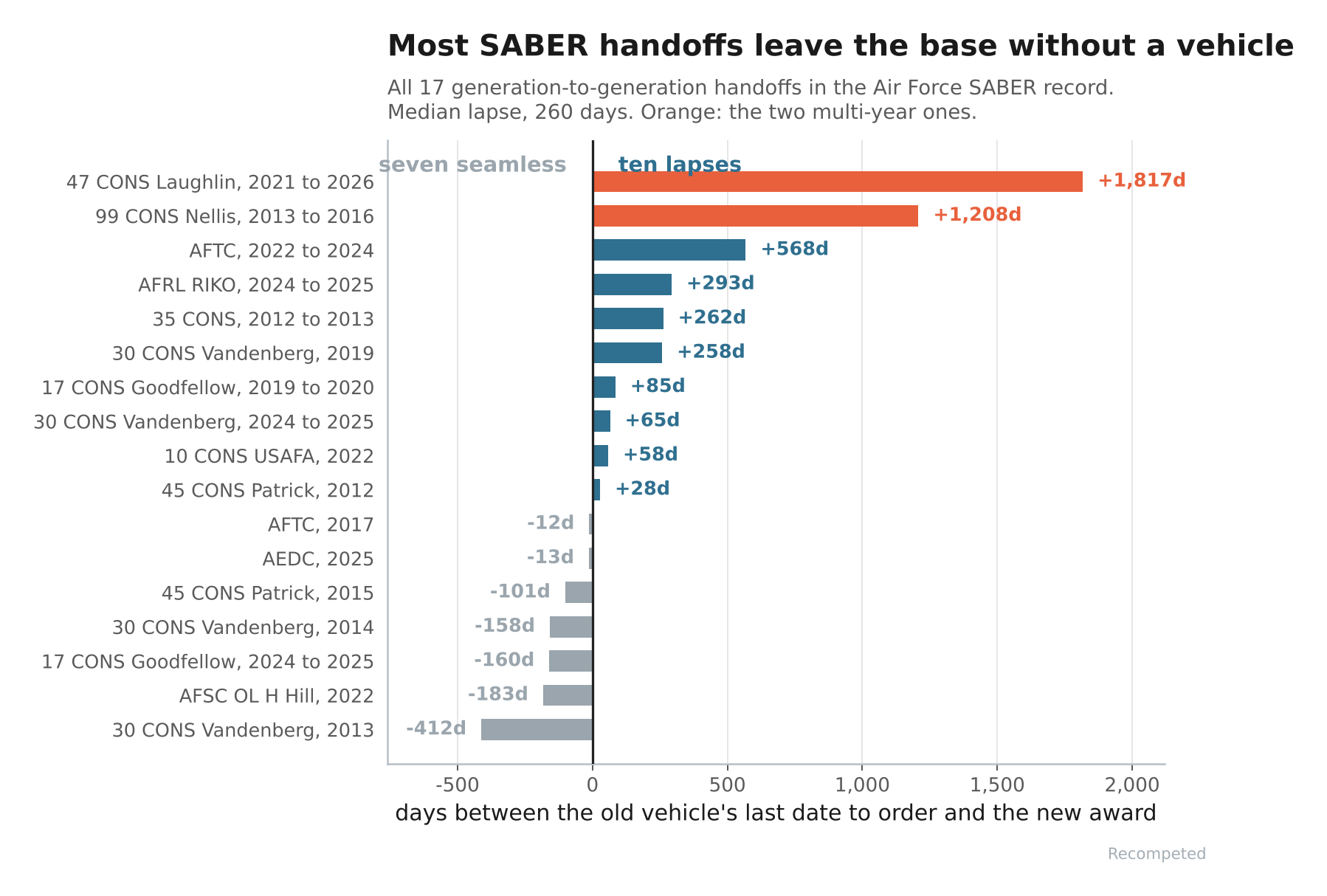

Eleven of the 34 activities have run more than one SABER generation, which gives 17 observable handoffs. Ten of them left a gap (chart below), and the median lapse across those ten is 260 days.

The two orange bars are the ones worth your attention, because both closed inside the last six months:

  • 47 CONS at Laughlin: FA309916D0001 stopped taking orders May 3, 2021. The follow-on, FA309926D0003, started April 24, 2026. 1,817 days, the longest in the record.
  • 99 CONS at Nellis: the 2013-to-2016 handoff above, 1,208 days, second longest. The current Nellis gap at 1,745 days is not plotted, because the Sept. 30 award has not reached the award database yet. Only the board has it.

Everything else is under 600 days. So the shape is not a smooth distribution of delay; it is a tight cluster of ordinary slippage with two outliers hanging off it, and both outliers belong to bases that just spent half a decade without their primary construction vehicle.

What a Base Does With No SABER

A lapsed SABER does not stop the work. The requirements keep arriving and the squadron buys them some other way, which is the part worth watching if you build in this space.

Nellis is the clean example.

On Sept. 22, 2025, deep into the gap, the 99th CONS awarded FA486125D0010 and FA486125D0012, two separate paving IDIQs under NAICS 237310, one for Nellis and one for Creech, both HUBZone set-asides, both to Ace Engineering, both drawing exactly one offer.

That is the signature. When the broad-scope vehicle is gone:

  • Single-trade IDIQs appear on the activity code, carrying narrow NAICS instead of 236220.
  • Offer counts collapse. The SABER that replaced them pulled six offers; the paving contracts pulled one each.
  • The set-aside moves. The old Nellis SABER was HUBZone, the new one competitive, and the stopgaps went HUBZone again.

None of that shows up if you are watching for the recompete. It shows up if you are watching the activity code.

Where the Next One Opens

Seven of the 24 live SABER vehicles stop taking orders inside 18 months, across five activities: three at AFSC OL H at Hill and one at FA8501, all four on March 30, 2027, then 10 CONS at USAFA on May 24, 48 CONS on Aug. 31, and 23 CONS on Oct. 31, 2027.

And one gap opened eight days ago. FA930120D0004 at AFTC ran its ordering period out on Sept. 30, 2026, and nothing has replaced it on that activity code.

Fifteen of the 34 activities have no live SABER at all right now. Some of those stopped running the program on purpose, and we are not going to pretend the record tells us which.

What it does tell you is that a closed ordering period on a base engineering vehicle is the normal state of affairs roughly as often as a live one.

Final Thoughts

The useful read here is about where the clock actually starts. A SABER recompete does not behave like a services follow-on with a bridge holding the line; there is no bridge, because an IDIQ that stops taking orders simply stops, and the base reverts to buying construction one trade at a time.

So the interval to plan against is not the one between solicitation and award. It is the one between the last date to order and whenever the next vehicle lands, and across the Air Force record that has run 260 days at the median and five years at the tail.

Nellis closed its gap on Sept. 30. Four other activities have theirs scheduled to open in March.

Thanks for reading.
